WEEK 28 · JULY 2026
APAC Data Centre Weekly
Malaysia’s data center boom is now a GDP lifeline, while Singapore and Japan brace for identity-driven regulatory crackdowns after high-profile breaches.








Editor’s note
Substations, Not Slide Decks
Lee Heggan · Editor · Week of 6 July 2026
This week drew a clean line between markets moving electrons and markets moving press releases.

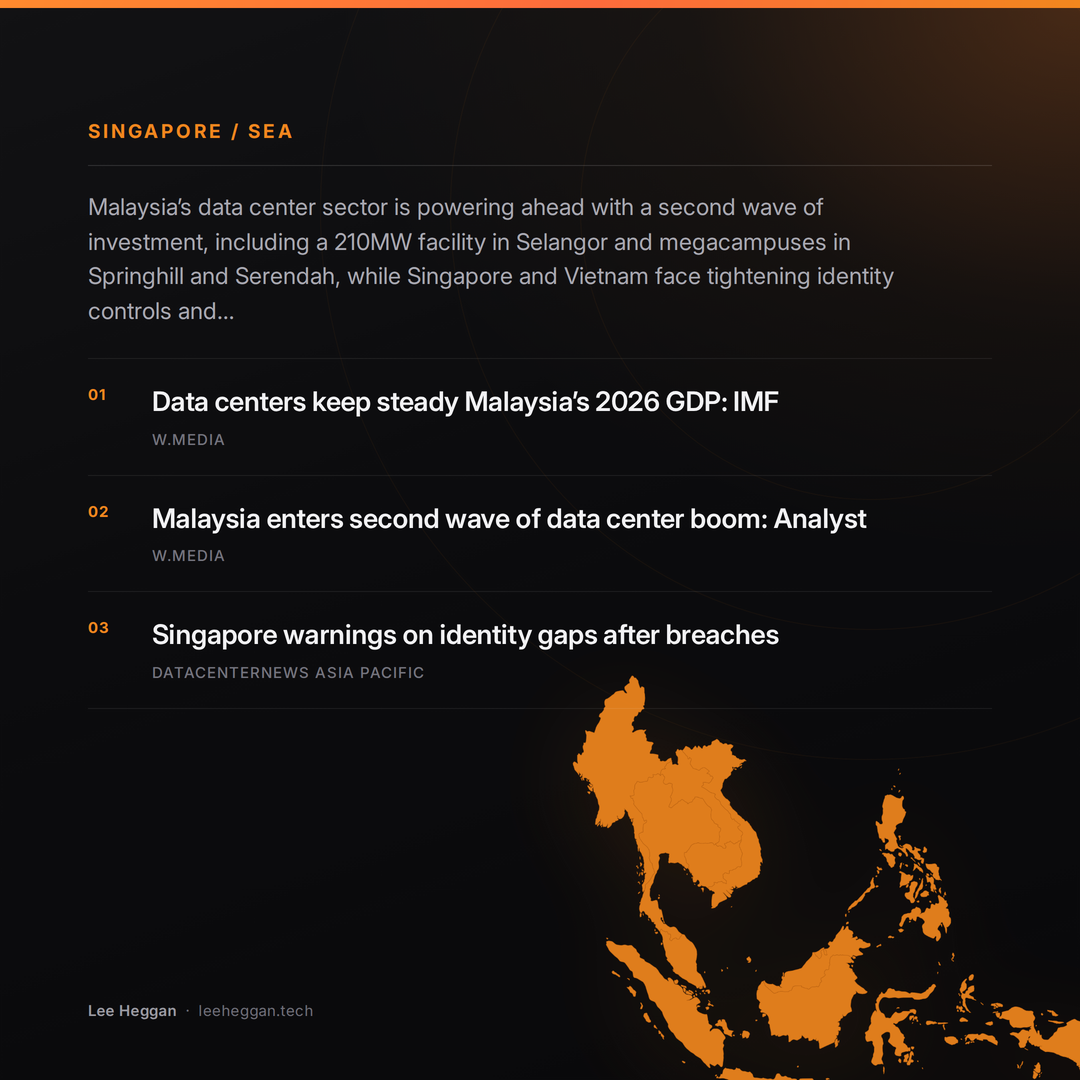

On the funded side: Japan's power companies committing to build or reinforce 30 substations for AI demand. That is the least glamorous story of the fortnight and the most important. Japan already carries more capacity under construction than any APAC market — 1.9GW on our database, against 1.8GW live and 3.0GW planned. The bottleneck there has never been capital or land; it's interconnection queues gating a third of the planned book. Utilities pre-committing steel is how that queue clears. Follow the substation, not the ribbon-cutting.

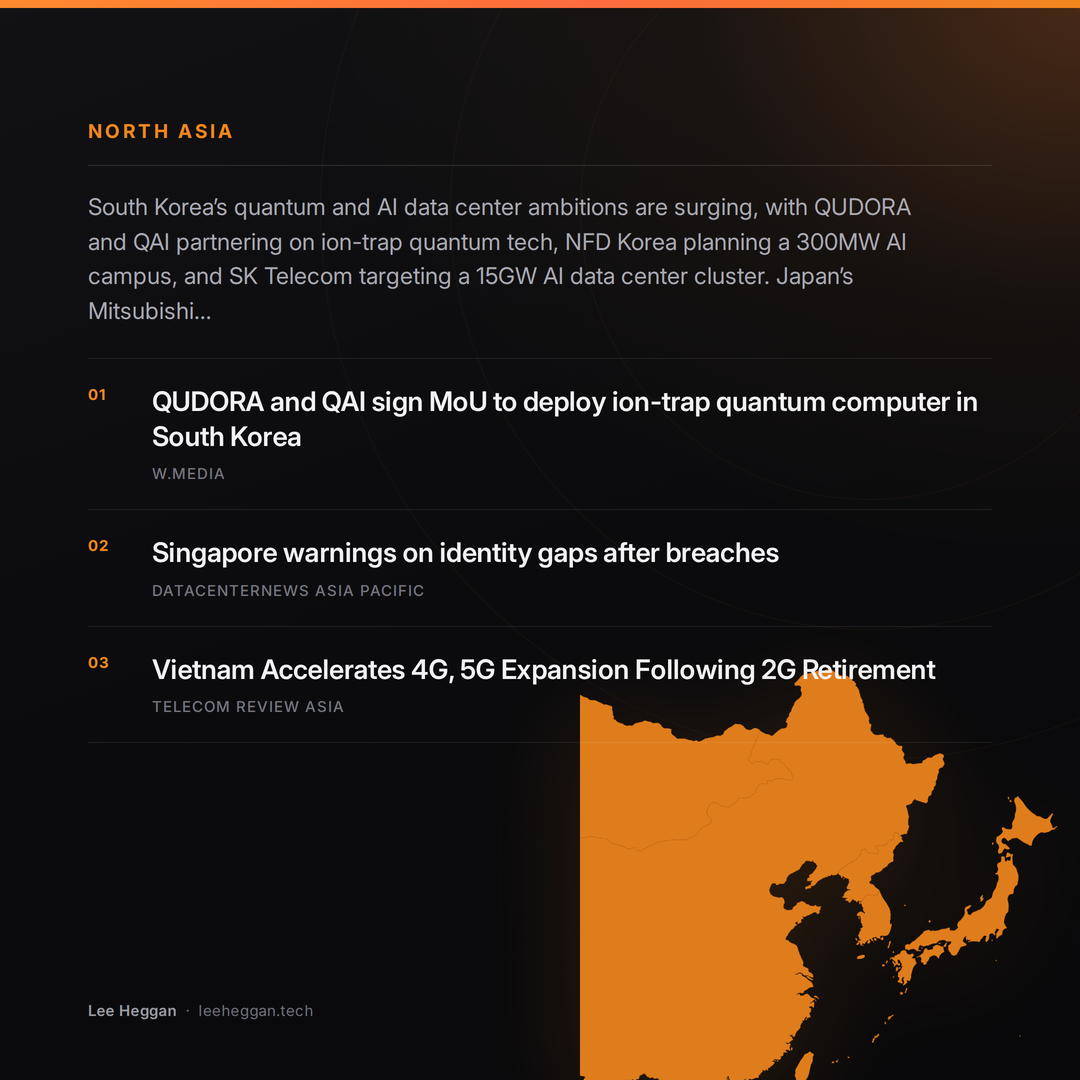

Set that against Korea. SK Telecom's 15GW cluster ambition is roughly twenty times the country's entire live base (737MW) and six times its whole pipeline. Seoul-area development is already paused on community and supply concerns; our region outlook has GPU builds redirecting to Japan and Singapore. Which is why Saemangeum — landing the AUG East cable, pitched as an AI gateway — is the tell: when you can't get power in Seoul, you sell greenfield. Markets rhyme. Singapore's moratorium built Johor; Korea's grid is building Saemangeum on paper.
Japan's own paper column filled too. Mitsubishi Estate's debut promises 2,500MW and $9.3bn — more than the entire country runs today, from a developer with no live DC in our base. Nvidia–Noetra's 140MW Vera Rubin cluster is the smaller, more credible number the same week. Treat the first as ambition, the second as a build.

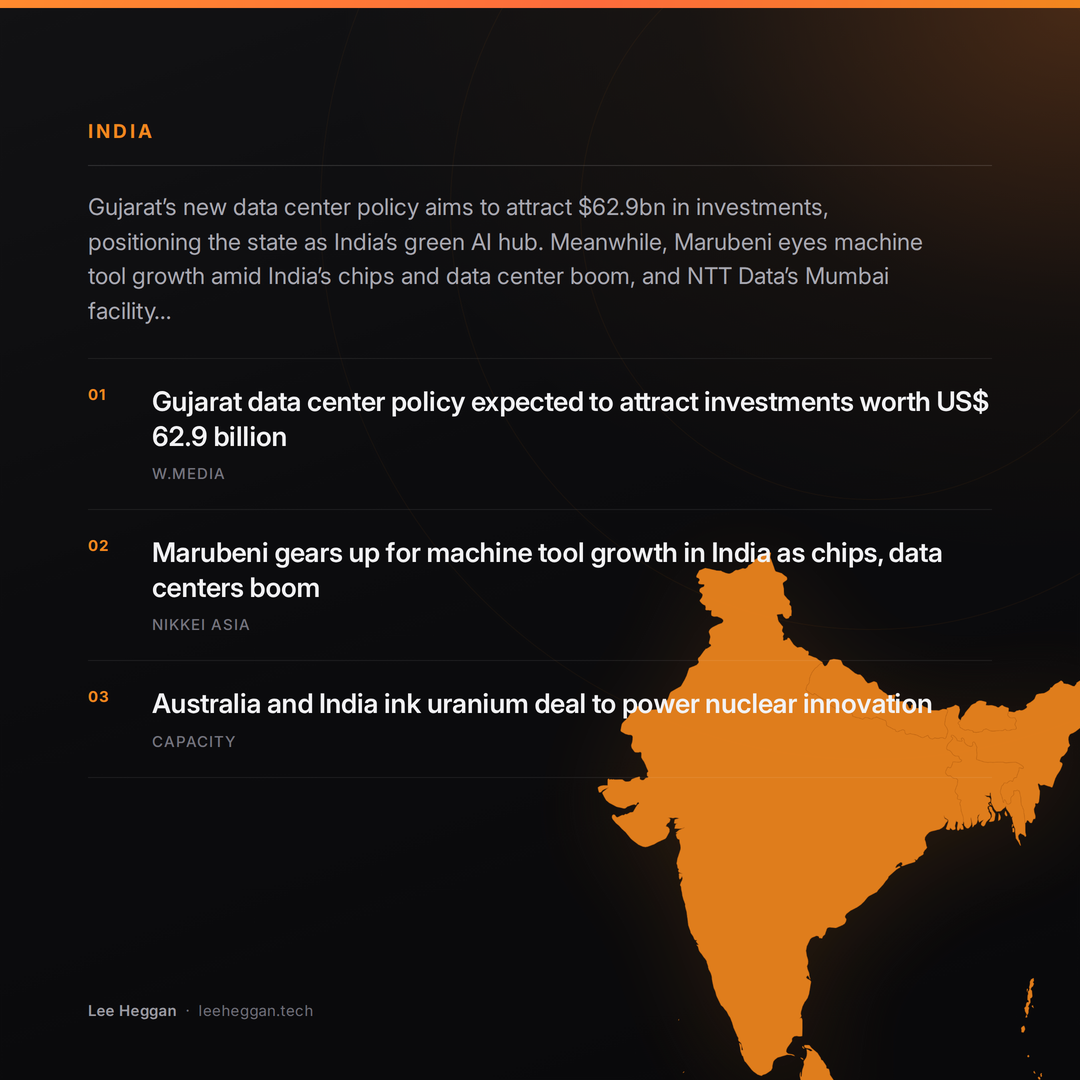

On capital, the memory is instructive. IFC's $175m into AirTrunk's Johor campuses and AirTrunk's targeted $1.5bn Singapore REIT listing for September–October are the 2026 financing-innovation phase in miniature — development-finance debt on one end, public-market recycling on the other, from the operator Blackstone and CPPIB took private for $16bn. CapitaLand Ascendas selling a Singapore asset for $155.6m is the same recycling reflex. Stabilised Japan and Singapore assets are becoming the exit; growth capital chases Johor and India.

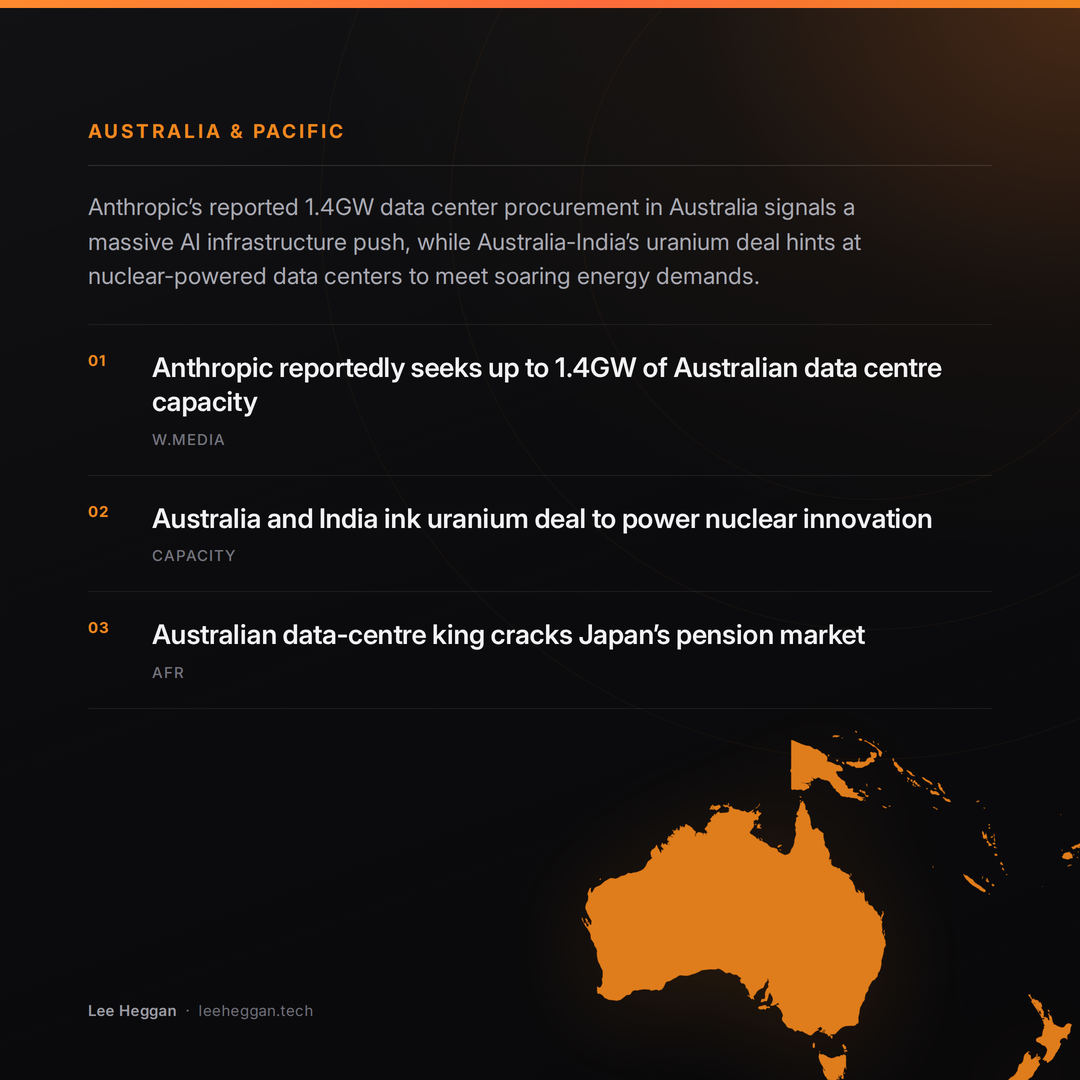

And demand keeps arriving ahead of supply. Anthropic reportedly wants up to 1.4GW of Australian capacity — against an installed base of 1.4GW and a pipeline already eight times that. The tenant demand is real; whether any of it energises is the question. Australia's build book remains the region's most inflated relative to what's running.
Region-wide, 52GW sits on paper against 15GW live, and only about 4.7GW carries a dated delivery year. That ratio hasn't moved. Conversion, not ambition, remains the whole story.
Watch
Whether Japan's 30 planned substations actually shorten interconnection timelines — the mark of whether its APAC-leading 1.9GW under construction converts to live megawatts rather than staying queued.
Sources this week
DataCenterNews Asia Pacific
Telecom Review Asia
Data Center Dynamics
SubTel Forum
SubTel Forum
Telecom Review Asia
DataCenterNews Asia Pacific
Data Center Dynamics
Data Center Dynamics
DataCenterNews Asia Pacific
