WEEK 31 · AUGUST 2026
APAC Data Centre Weekly
This week brought key developments across the APAC data centre landscape.







Editor’s note
Johor Turns Into a Trading Floor
Lee Heggan · Editor · Week of 27 July 2026

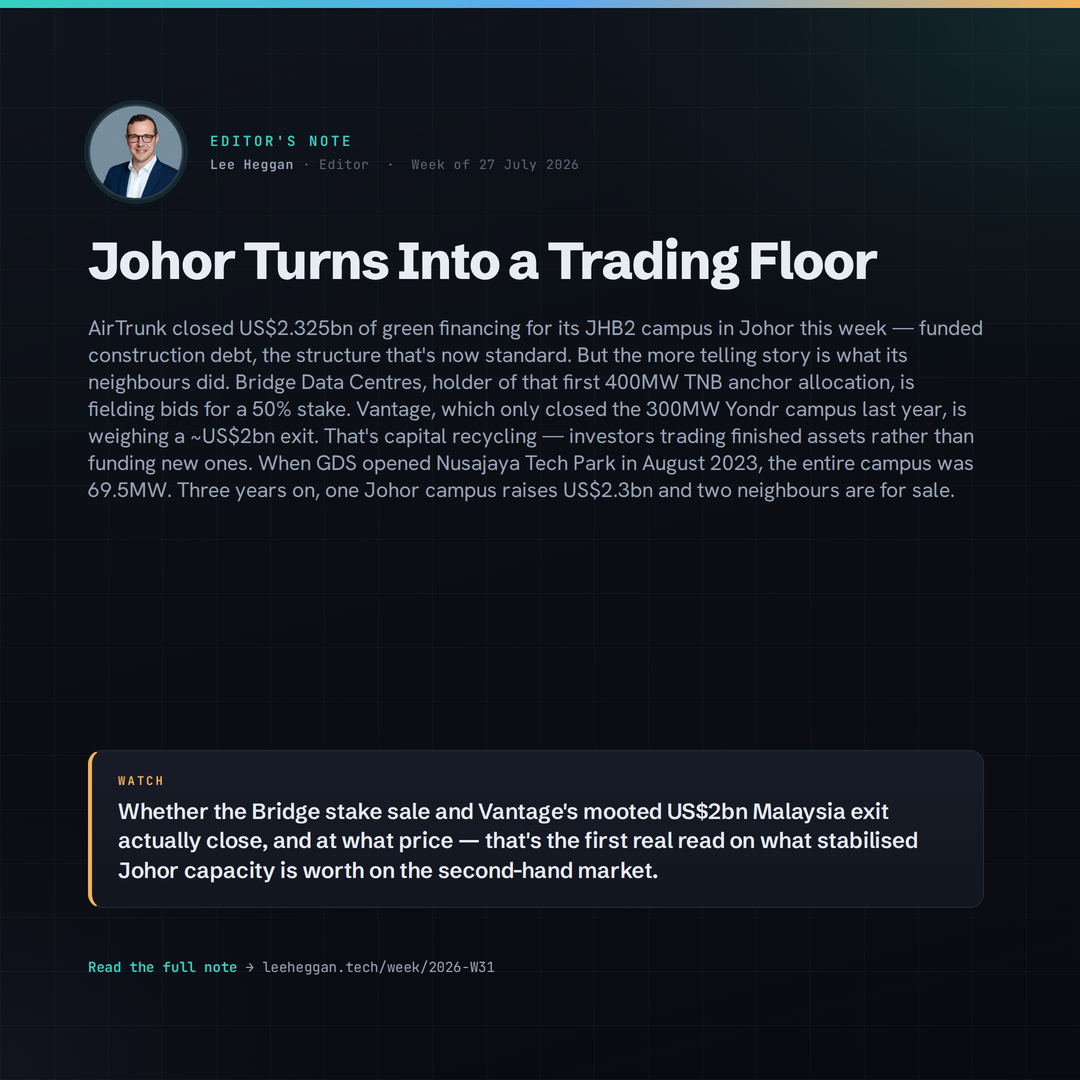

Johor stopped being a build story this week and started looking like a trading floor.
The funded headline was AirTrunk closing US$2.325bn of green financing for its JHB2 hyperscale campus in Johor Bahru — real construction debt, the sustainability-linked structure that's now the default here. AirTrunk already carries north of 500MW live across the region, and with JHB2 now in the book its under-construction pipeline passes 1GW. This is money moving, not a slide deck.
But the sharper signal was what happened around it. Bridge Data Centres — the outfit that landed the first TNB allocation that actually read like an anchor lease, 400MW at Ulu Tiram — is fielding bids for a 50% stake, with SK Telecom and GIC among the names. And Vantage, which only closed the 300MW+ Yondr Johor campus last year on GIC and ADIA money, is now weighing a roughly US$2bn sale of its Malaysia assets.
That's capital recycling — investors selling finished assets to each other rather than funding new ones — and it's the mark of a market that has grown up. You don't get a second-hand market until you have stabilised assets worth trading rather than raw land and allocations. Sovereign and PE money is now buying and selling Johor, not just funding it. The one flag worth holding: Vantage looking to exit barely a year after buying in is either smart portfolio management or a hint that someone thinks the froth has peaked. We'll know when the price prints.
It is worth remembering how fast this happened. When GDS opened Nusajaya Tech Park in August 2023, the entire campus was 69.5MW of IT load, and that was the moment Johor stopped being theoretical — the first proof the state could host something real. Three years on, a single Johor campus raises US$2.325bn in one go, and two of its neighbours are being sold to sovereign and private-equity money. Markets rhyme, but they do not usually rhyme this quickly.
The announcement pile grew too, and it deserves less weight. DeepSeek is reportedly planning a 1GW data centre at Ulanqab in Inner Mongolia, targeting part of that capacity by late 2027 or early 2028 — a direction of travel, but no project financing named and no ground broken. SK Telecom launched SK Hyper, the wholly-owned vehicle for the 15GW build we flagged a fortnight ago, with KRW750bn committed and a first 5GW aimed at Ulsan and the Yeongnam region by 2029. That is a real schedule attached to a very large number, and it still sits against a Korean live base of circa 700-800MW — the gap is what has to be built. Naver's expansion of its Sejong site to 200MW with Brookfield and Nvidia is smaller but far more concrete.
Thailand keeps building quietly under all this: True IDC is chasing a US$2bn loan for a new campus, against a Thai book that shows the best part of 800MW under construction against a live base still under 200MW — one of the region's biggest under-construction-to-live ratios, and worth watching as it converts.
The week's lesson is an old one. Funded debt and closed sales tell you where the market actually is. The gigawatt announcements tell you where people wish it were.
Johor is now doing both at once — building on borrowed money and selling what it's already built.
Watch
Whether the Bridge stake sale and Vantage's mooted US$2bn Malaysia exit actually close, and at what price — that's the first real read on what stabilised Johor capacity is worth on the second-hand market.
Sources this week
